Greggs Finmere - EG On The Move
Kiosk
767 sq ft
9-Day Site Installation
Finmere, Oxfordshire, UK
Retail / Drive-To
2 Modules

In this post

Below is an overview of this post, feel free to skip ahead.
No items found.

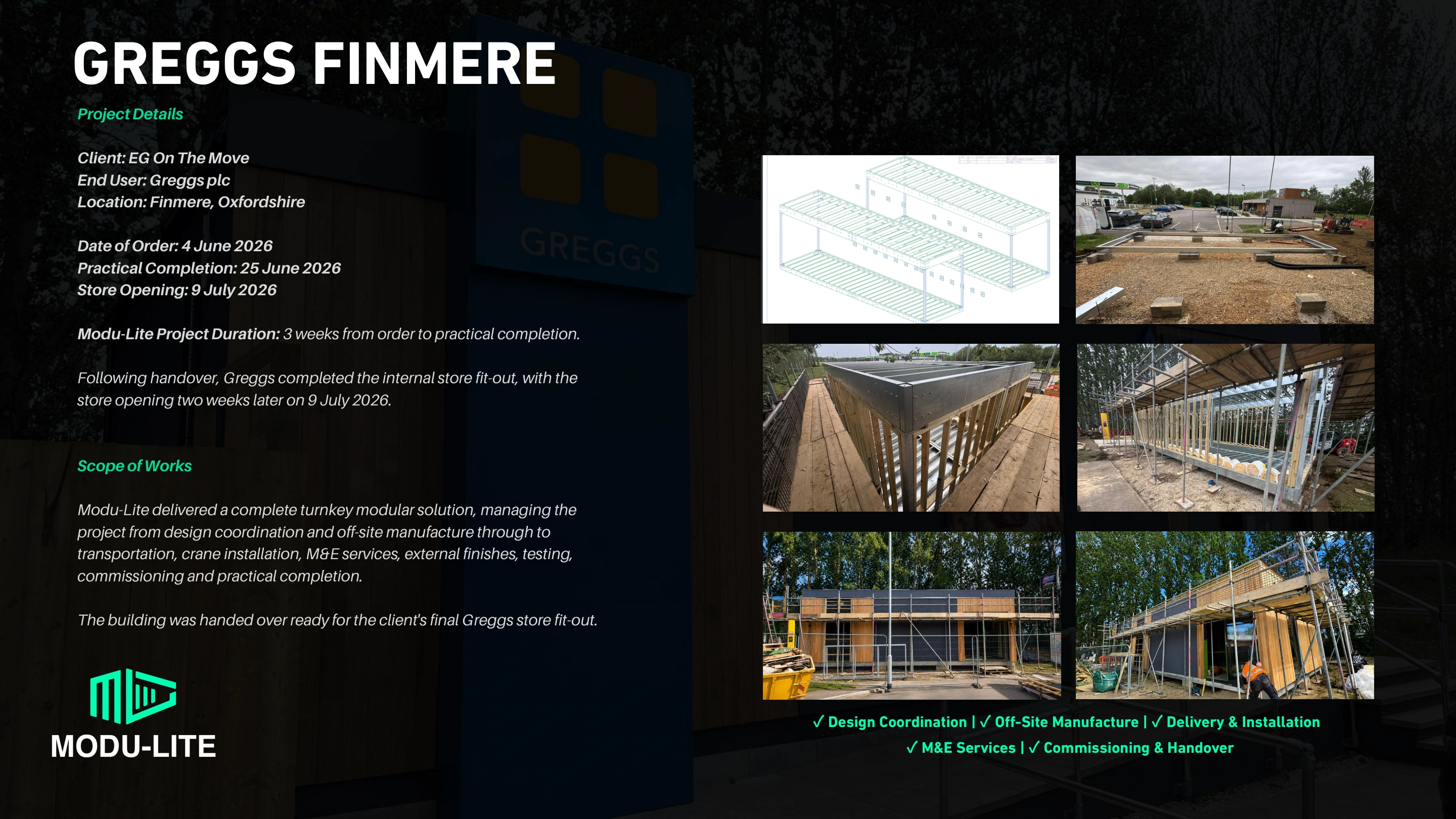

Project Details

Client: EG On The Move

End User: Greggs plc

Location: Finmere, Oxfordshire

Date of Order: 4 June 2026

Practical Completion: 25 June 2026

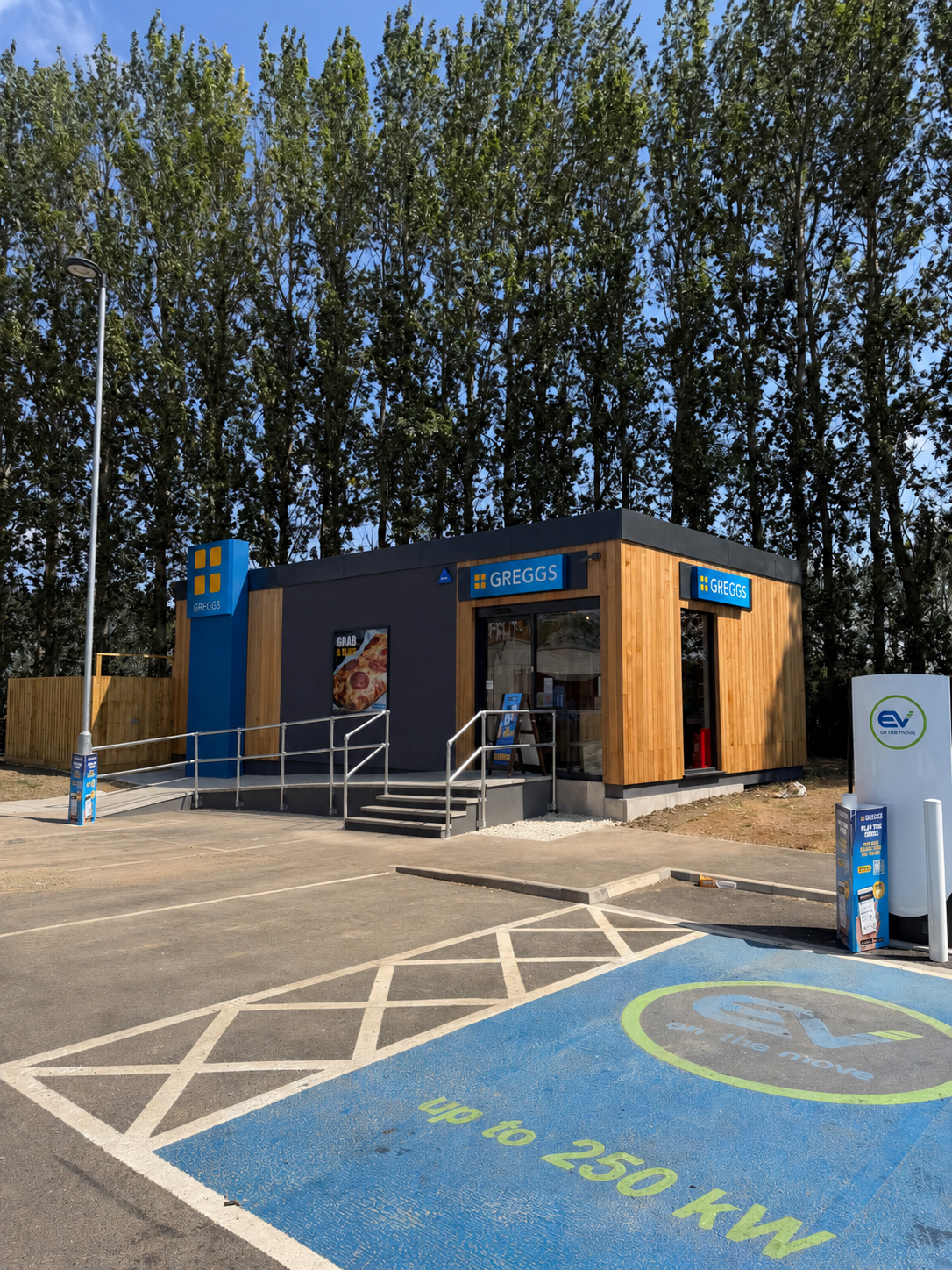

Store Opening: 9 July 2026

Modu-Lite Project Duration: 3 weeks from order to practical completion.

Following handover, Greggs completed the internal store fit-out, with the store opening two weeks later on 9 July 2026.

Project Timeline

Day 1 - Live on Site

With groundworks and foundations already prepared by others, Modu-Lite Build mobilised quickly and efficiently. Day 1 saw the structural base frame installed and the build programme officially underway. From the outset, the focus was on precision and pace — setting the tone for the days that followed.

For operators and developers used to lengthy on-site programmes, this kind of immediate, structured start is one of the most visible benefits of the Modu-Lite approach. Every element arrives ready to install, and every day on site is a productive one.

This week, Modu-Lite Build commenced works at Greggs Finmere for EG On The Move, with the structural base frame installed on Day 1 and the project now progressing through its construction programme.

Days 1–3 - Structure Rising

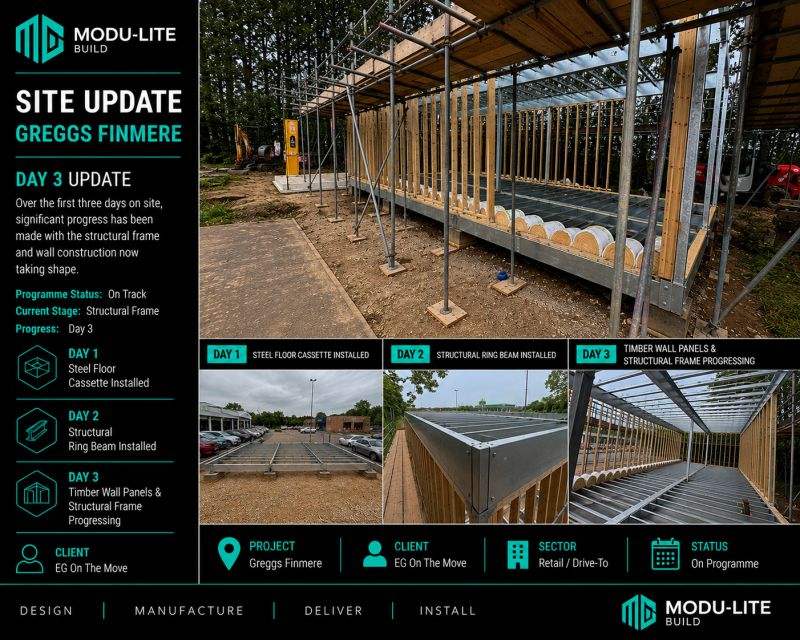

The speed of early progress set this project apart. The steel floor cassette was installed on Day 1, the structural ring beam followed on Day 2, and by Day 3 the timber wall panels and structural frame were already progressing. In less than 72 hours, the bones of a fully commercial retail building were in place.

This is possible because the heavy lifting happens in our off-site manufacturing environment before a single vehicle arrives on site. Components are pre-engineered, pre-sized and ready to connect — meaning the on-site team can move at a pace that simply isn't achievable with traditional build methods.

Only a few days into the programme and the transformation on site is already clear.

Mid-Programme - Building Takes Shape

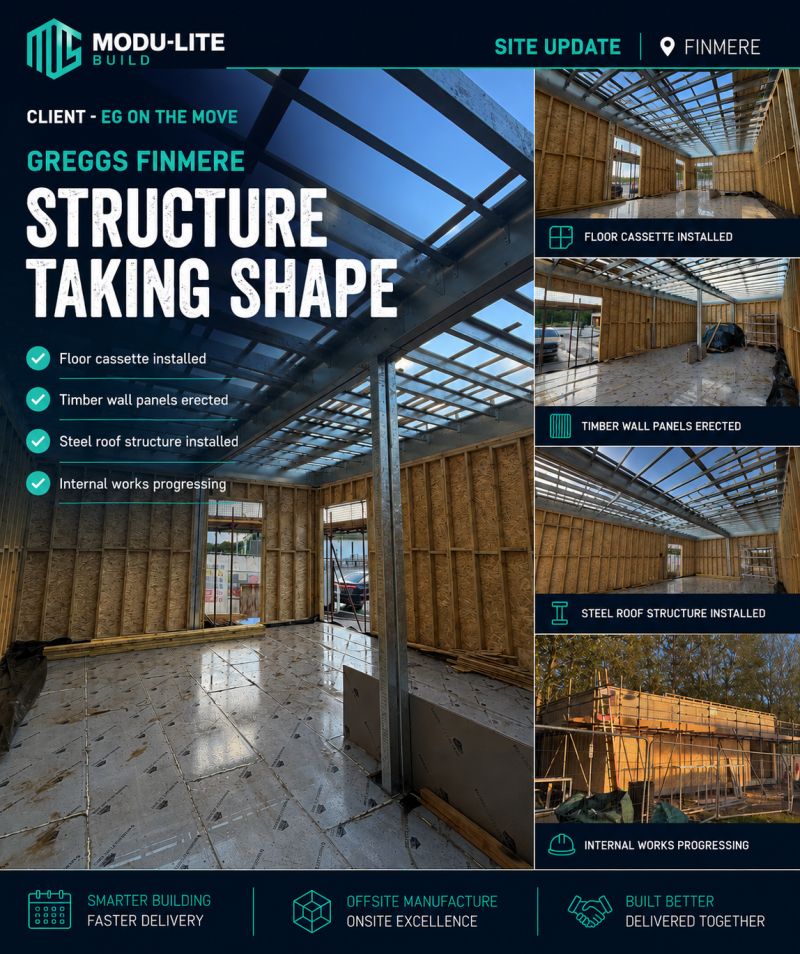

With the floor cassette, timber wall panels and steel roof structure all installed, the building was rapidly becoming recognisable as the finished unit it would soon become. The structure was complete, the envelope was closing in, and the quality of finish was already evident.

For the client and wider project team, this stage represents a critical milestone — the point at which programme confidence becomes programme certainty. The building is up, it is square, and it is progressing exactly as planned.

In today's market, successful project delivery isn't just about building faster — it's about creating programme certainty and reducing risk.

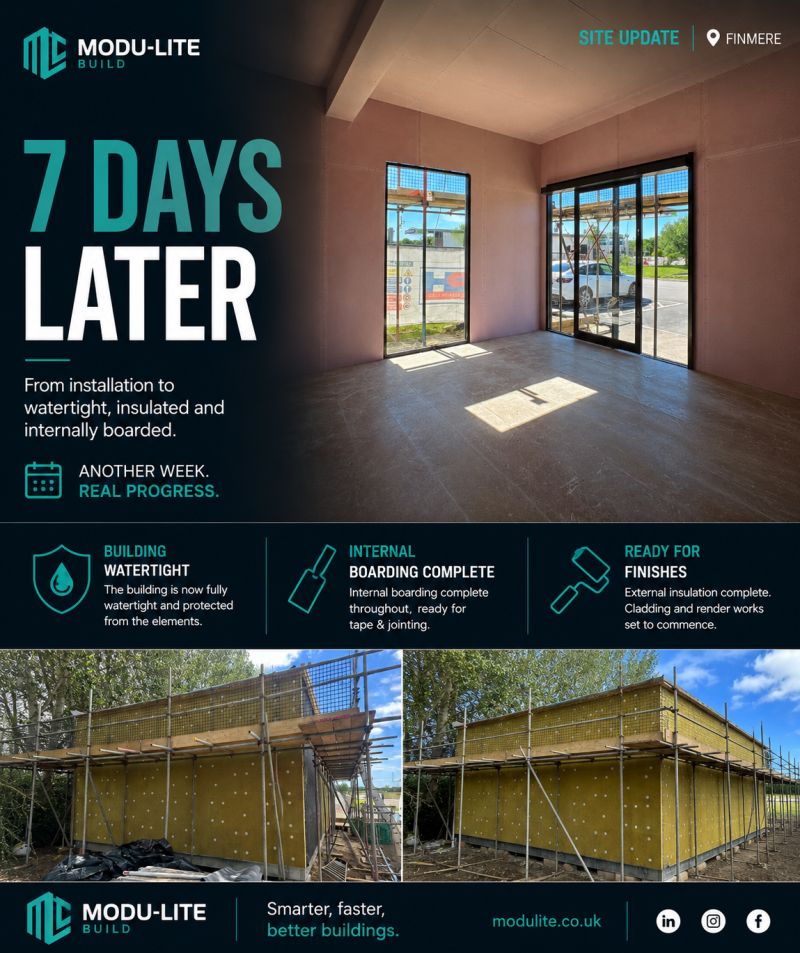

Day 7 - Watertight & Boarded

Perhaps the most striking milestone of the entire build. Just seven days after installation began, the building was fully watertight, externally insulated and internally boarded throughout. What had arrived on site as flat-packed components was now a secure, weathertight structure ready for the finishing trades.

Tape and jointing was scheduled to begin immediately, with external cladding and render works to follow. The Greggs fit-out team were confirmed to start the following Monday — a handover of the internal envelope that most clients wait months to reach, delivered here in a single week.

For anyone evaluating the real-world value of modular construction, this is the moment that makes the case.

From a flat-packed steel delivery to watertight, insulated and internally boarded.

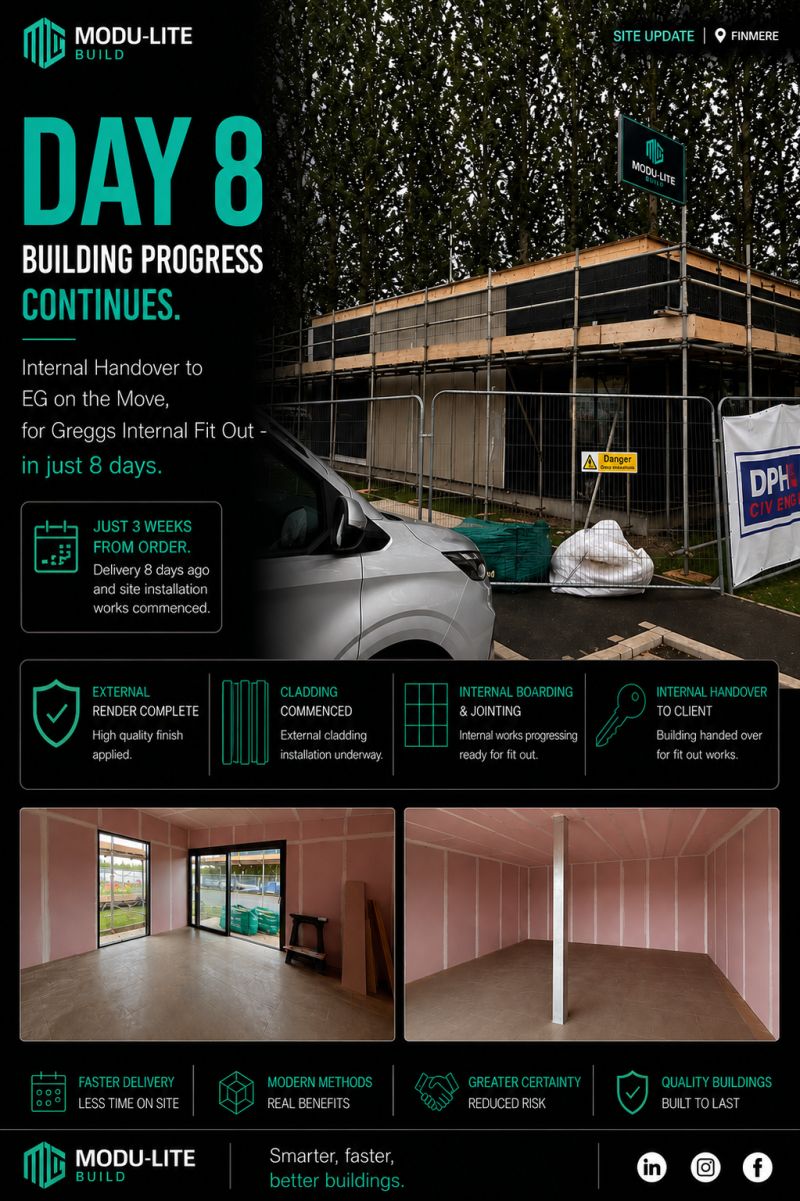

Day 8 Onwards - External Finishes Underway

With the structure complete and the internal trades progressing, attention turned to the external envelope. Render was underway, cladding was being fixed, and the building was beginning to take on the appearance of the finished Greggs unit it was always destined to become.

At this stage, the project was firmly on track for internal handover within three weeks of the original order — a timeline that reflects not just the speed of the Modu-Lite system, but the planning, coordination and commitment of everyone involved in delivering it.

From order to internal handover in just 3 weeks demonstrates what’s possible with a well-planned offsite approach and a committed team.

Project Complete — Shell Handed Over Snag-Free

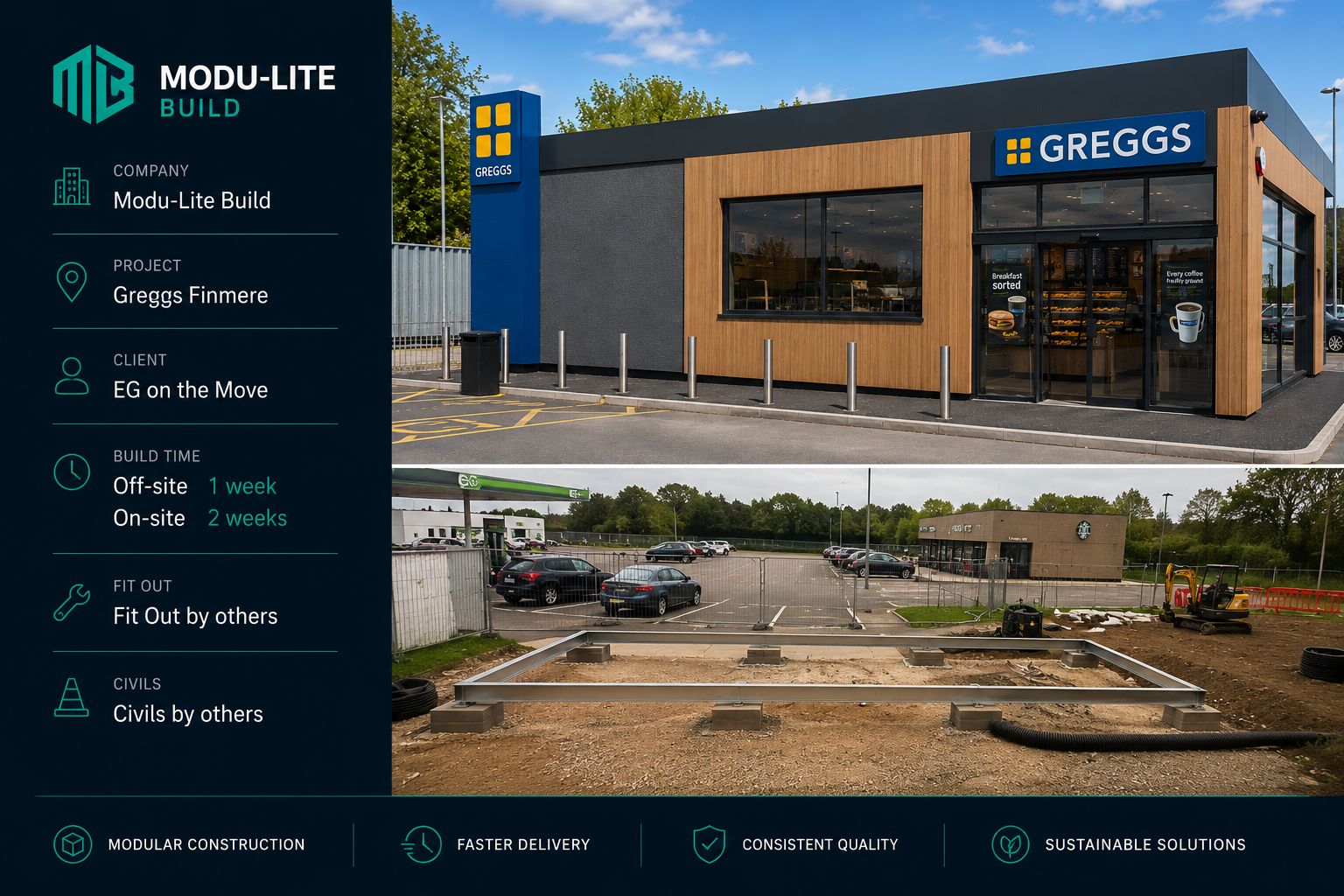

The completed modular shell was handed over to EG On The Move snag-free, with the Greggs fit-out team stepping in to complete the interior finish. From initial enquiry to internal handover in just three weeks — on programme, on quality, and exactly as promised.

This is what Modu-Lite Build does. If you are planning a roadside retail unit, a drive-to development, or a food-to-go building and you need it delivered quickly without compromising on quality, we would love to hear from you.

Great achievement for Modu-Lite Build to have handed the shell over to our client EG On The Move today.

Get in touch today to discuss your next project.
